TABLE OF CONTENTS
Construction Activities
undertaken during the Reporting Month
Statues of Environmental
Licensing and Permitting
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Implementation Status of
Environmental Mitigation Measures
Implementation Status of
Event and Action Plans
Summary of Complaint,
Warning, Notification of any Summons and Successful Prosecution
Monitoring Schedule for
Next Month
lIST OF TABLES
Table I............... Summary
of Complaint/Summons/Prosecution in the Reporting Month
Table
1.1............ Key
Project Contacts
Table
1.2............ Summary
of Environmental Licensing and Permit Status
Table
2.1 ........... Locations
for Air Quality Monitoring
Table
2.2 ........... Air
Quality Monitoring Equipment
Table
2.3 ........... Impact
Dust Monitoring Parameters, Frequency and Duration
Table
3.1 ........... Noise
Monitoring Stations
Table
3.2 ........... Noise
Monitoring Equipment
Table
3.3 ........... Noise
Monitoring Parameters, Frequency and Duration
Table
3.4 ........... Baseline
Noise Level and Noise Limit Level for Monitoring Stations
Table
4.1............ Quantities
of Waste Generated from the Project
Table
6.1............ Observations
and Recommendations of Site Inspections
Table
6.2............ Status
of Required Submission under Environmental Permit
lIST OF FIGUREs
Figure 2 Project Organisation for
Environmental Monitoring and Audit
Figure 3 Location
of Monitoring Station
lIST OF APPENDIces
Appendix A Action and Limit Levels
for Air Quality and Noise
Appendix B Copies of Calibration
Certificates
Appendix C Weather Information
Appendix D Environmental
Monitoring Schedules
Appendix E 1-hour TSP Monitoring Results and Graphical
Presentations
Appendix F 24-hour TSP Monitoring
Results and Graphical Presentations
Appendix G Noise Monitoring Results
and Graphical Presentations
Appendix H Summary of Exceedance
Appendix J Environmental
Mitigation Implementation Schedule (EMIS)
Appendix L Summary of Waste Generation and Disposal
Records
Appendix M Construction Programme
Introduction
1.
This is the 7th Monthly Environmental Monitoring
and Audit (EM&A) Report prepared by the Environmental Team (ET), Cinotech Consultants Ltd., for Contract No. HY/2019/13 “Central
Kowloon Route – Buildings, Electrical and Mechanical Works”. This report
summarized the monitoring results and audit findings of the EM&A programme
under the issued EP No. EP-457/2013/D, and in accordance with the EM&A programme
in Central Tunnel (Ho Man Tin Area) during the reporting period from 1st
July 2024 – 31st July 2024.
2.
The major site activities
undertaken in Central Tunnel (Ho Man Tin Area) in the reporting month included:
Environmental
Monitoring Works
3.
Environmental monitoring
for the Project was performed in accordance with the EM&A Manual and the monitoring results were checked and reviewed.
Joint weekly site inspections with the representative of ET, Engineer
Representative and the Contractor for Contract No. HY/2019/13 were conducted on 2, 9, 16, 23, & 30 July 2024, whereas joint site inspection with
the representative of IEC was conducted on 16 July 2024. The implementation of the environmental mitigation measures,
Event and Action Plans and environmental complaint handling procedures were
also checked.
4.
A summary of the non-compliance (exceedance) during the reporting month (July 2024) and the investigation results and/or follow-up actions
is provided below:
Complaint Handling,
Prosecution and Public Engagement
5.
Summary of complaint/summons/prosecution in the
reporting month is tabulated in Table I.
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
|
Number |
Brief Description |
|||
Complaints
Received |
0 |
- |
- |
- |
Notification
of Summons and Prosecutions Received |
0 |
- |
- |
- |
Reporting
Changes
6.
There were no reporting
changes during the reporting month.
Future
Key Issues
7.
The key works or activities will be
anticipated in the coming two months are as
follows:
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer
Representative |
Mr. Tommy
Wong |
3695 0419 |
Cinotech |
Environmental
Team |
Ms.
Betty Choi |
2151 2072 |
ERM |
Independent
Environmental Checker |
Ms.
Mandy To |
2271 3113 |
GCL |
Contractor |
Mr. Sampson
Lo |
9752 9118 |
Permit / License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental Permit (EP) |
|||
EP-457/2013/D |
15
Jun 2021 |
N/A |
Valid |
Notification of Construction Works under
Air Pollution Control Ordinance (APCO) |
|||
457345 |
19
Jun 2020 |
End
of Project |
Valid |
Billing Account for Construction Waste
Disposal |
|||
7037679 |
26
Jun 2020 |
N/A |
Valid |
Registration of Chemical Waste Producer –
Ho Man Tin |
|||
5213-236-G2347-61 |
28
Nov 2023 |
N/A |
Valid |
Wastewater Discharge Licence - Ho Man Tin |
|||
WT10002215-2023 |
2
Feb 2024 |
31
Jan 2029 |
Valid |
Construction Noise Permit - Ho Man Tin |
|||
GW-RE0218-24 |
1
Mar 2024 |
31
Aug 2024 |
Superseded by GW-RE0561-24 |
GW-RE0561-24 |
9 May 2024 |
29 Oct 2024 |
Valid |
Construction Noise Permit for Works at Ho
Man Tin (Special Case for concrete pump truck) |
|||
GW-RE0399-24 |
28
Mar 2024 |
27
Sep 2024 |
Valid |
Monitoring Stations |
Locations |
Location of Measurement |
M-A3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(above 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Calibrator |
TISCH TE-5025A |
3864 |
1 |
1-hour TSP Dust Meter |
Dust Monitor System OC-9200 |
OC20210316224101 |
1 |
High Volume Sampler |
TE-5170 c/w of TSP sampling
inlet |
2204 |
1 |
Wind Anemometer |
C-OC-9200-wind |
OC20210316224101 |
1 |
Parameters |
Frequency |
1-hour TSP |
Three times / 6 days |
24-hour TSP |
Once / 6 days |
Monitoring Stations |
Locations |
Location of Measurement |
M-N3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(above 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Sound Calibrator |
SOUNDTEK ST-120 |
181001636 |
1 |
Hangzhou Aihua Instruments Co., Ltd. AWA6021A |
1023253, 1023064 |
2 |
|
Integrating Sound Level Meter |
SVANTEK SVAN 979 |
27189 |
1 |
BSWA Technology BSWA 308 |
570187, 580156 |
2 |
Monitoring Stations |
Parameter |
Period |
Frequency |
Measurement |
M-N3 |
L10(30 min.) dB(A) L90(30 min.) dB(A) Leq(30 min.) dB(A) |
0700-1900 hrs on normal weekdays |
Once per week |
Façade |
Monitoring
Stations |
Baseline Noise Level, dB (A) |
Noise
Limit Level, dB (A) |
M-N3 |
67.7(1) (at 0700 –
1900 hrs on normal weekdays) |
70(*) (at 0700 –
1900 hrs on normal weekdays) |
(*) Noise Limit Level is 65 dB(A) during school
examination periods.
Note (1): The noise level due to the construction
work (CNL) was calculated by the following formula:
CNL = 10 log
(10MNL/10 – 10BNL/10)
Remarks: MNL =
Measured Noise Level,
BNL = Baseline Noise Level
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting
Period |
Total
Quantity Generated (in
'000m3) |
Disposed
as Public
Fill (in '000m3) |
Others,
e.g. general
refuse (in '000m3) |
Metals (in
'000kg) |
Paper/cardboard Packaging (in
'000kg) |
Plastics (in
'000kg) |
Chemical
waste (in '000kg) |
July 2024 |
0.362 |
0.362 |
0.395 |
0 |
0 |
0 |
0 |
Parameters |
Date |
Observations |
Follow-up
Actions |
Water Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Air Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Noise |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Waste / Chemical
Management |
2 July 2024 |
General refuse should be disposed of regularly. |
General refuse has been
removed. |
Drip tray should be provided for chemicals |
Drip trays have been provided. |
||
Land
Contamination |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
EP Condition (EP-457/2013/D) |
Submission |
Submission Date |
Condition
3.4 |
Monthly
EM&A Report (June
2024) |
12 July 2024 |
I. Introduction
This is the 59th Monthly
EM&A Report prepared by Fugro Technical Services Limited for the Contract
No. HY/2018/08 Central Kowloon Route – Central Tunnel. The Contract No.
HY/2018/08 commenced on 19 September 2019. This report summarized the
monitoring results and audits findings of the EM&A programme under the
issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A Manual
during the reporting period from 01/07/2024 to 31/07/2024.
II. Summary of Main Works
Undertaken and Key Measures Implemented
The main construction works
carried out in the reporting period were as follow:
· Invert, lining and OHVD construction.
Yau Ma Tei
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Demolish of noise enclosure.
Ma Tau Kok
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Backfilling of C&C area.
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Backfilling and road reinstatement.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man
Tin site surface was substantially completed. The site had been handed over to
Contract No. HY/2019/13 on 30 December 2023.
III. Summary of Exceedances,
Investigation and Follow-up
The last impact monitoring
conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023.
Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental
Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3
and M-N3 are presented in the monthly EM&A Report prepared by Contract No.
HY/2019/13.
No Action and Limit Level
exceedance was recorded for construction dust monitoring in the reporting
month.
No Action and Limit Level
exceedance was recorded for construction noise monitoring in the reporting
month.
IV. Complaint Handling,
Prosecution and Public Engagement.
No complaints were received in the reporting month.
The complaint cases in July
2024 are summarized in Table I.
Table I Environmental Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
No notification of summons
and prosecutions were received in the reporting period.
No public engagement
activities were conducted in the reporting period.
V. Reporting Change
There were no reporting
changes during the reporting month.
VI. Future Key Issues
The main works will be
anticipated in the next reporting period are as follow:
Yau Ma Tei
· Plant and material lifting;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Demolish of noise enclosure & Gantry Crane.
Ma Tau Kok
· Plant and material lifting;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Backfilling of C&C area;
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Backfilling and road
reinstatement.
Ma Hang Chung Road
· Backfilling and road reinstatement.
The recommended mitigation
measures corresponding to the main works in the next reporting period are
listed as follow:
· Good relationship shall be maintained with the nearby sensitive
receivers/ stakeholders which may be affected by the construction works such as
providing better/ more detail information of the work nature and inform in
advance of the works to the nearby residents;
· All construction plants / machineries should be checked / serviced on a
regular basis during the courses of construction to minimize the emission of
noise generation and eliminate dark smoke emission;
· All C&D materials generated should be transported and stored at
temporary storage area. Suitable materials should be sorted for reuse on-site;
· Every vehicle shall be cleaned thorough at the designated wheel washing
area onsite;
· Wastewater generated from drilling shall be properly collected for reuse
or treated by wastewater treatment facilities before discharge;
· Provision of drip trays for equipment likely cause spillage of chemical /
fuel, and provide routine maintenance;
· Erecting temporary noise barrier for noisy Powered Mechanical Equipment
(PME) and deployment of Quality Powered Mechanical Equipment (QPME) as many as
practicable;
· Conditions in the Environmental Permit and License should be followed;
· All recommended mitigation measures specified in the approved EIA Report
and EM&A Manual shall be implemented;
· All vehicles should be cleaned before leaving the construction site to
ensure no muddy deposited by them on roads.
The following EP submissions
were submitted during the reporting month:
Table II Status of Required Submission under Environmental
Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (June 2024) |
10 July 2024 |
Contents
1.3 Construction Programme and Activities
1.4 Works undertaken during the month
1.5 Status of Environmental Licences, Notification and
Permits
2 ENVIRONMENTAL MONITORING
REQUIREMENTS
2.1 Construction Dust and Noise
Monitoring Locations
2.2 Construction Dust Monitoring
2.3 Construction Noise Monitoring
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.2 Construction Noise Monitoring
5 ENVIRONMENTAL COMPLAINT AND
NON-COMPLIANCE
5.1 Complaint Handling, Prosecution
and Public Engagement
5.2 Summary of Environmental
Non-Compliance
5.3 Summary of Monitoring Exceedance
8 CONCLUSION AND RECOMMENDATIONS
Tables
Table I – Environmental Complaints Log
Table II
– Status of Required Submission under Environmental Permit
Table 1.1 – Contact Information of Key
Personnel
Table 1.2 – Environmental Licenses,
Notification and Permits Summary
Table 2.1 – Construction Dust and Noise
Monitoring Location
Table 2.2 – Construction Noise Monitoring
Parameters, Frequency and Duration
Table 4.1 – Observations and Recommendation
of Site Inspection in the Reporting Period
Table 5.1 – Environmental Complaints Log
Table 6.1 – Status of Required Submission
under Environmental Permit
Figures
Figure 1 The Site Layout Plan of the Contract
Figure 2.1 The Location of the
Construction Dust and Noise Monitoring Stations (Ho Man Tin)
Figure 2.2 The Location of the
Construction Dust and Noise Monitoring Stations (Ma Tau Kok)
Figure 2.3 The Location of the
Construction Dust and Noise Monitoring Stations (Yau Ma Tei)
Appendices
Appendix A Construction
Programme
Appendix B Project
Organization Chart
Appendix C Event
and Action Plan
Appendix
D Implementation Status of Environment Mitigation Measures (Construction
Phase)
1.1.1 In order to meet the traffic
demand and relieve traffic congestion on the existing east-west roads across
Central Kowloon, Central Kowloon Route (CKR) (hereinafter referred to as “the
Project”) is proposed which is a 4.7 km long dual 3-lane trunk road in Central
Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road network on
Kai Tak Development and Kowloon Bay in East Kowloon.
1.1.2 The Central Kowloon Route –
Design and Construction Environmental Impact Assessment Report (Register No.:
AEIAR-171/2013) was approved with conditions by the Environmental Protection
Department (EPD) on 11 July 2013. An Environmental Permit (EP-457/2013) was
issued on 9 August 2013. A variation of EP (VEP-594/2021) was applied on 26 May
2021 and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.
1.1.3 Contract No. HY/2018/08
Central Kowloon Route – Central Tunnel (hereinafter referred to as “the
Contract”), is one of the contracts of CKR which included the construction of
the central tunnel, cut-and-cover tunnels at Yau Ma Tei and Ma Tau Kok and
construction of piles and diaphragm walls for Ho Man Tin ventilation building.
1.1.4 Fugro Technical Services
Limited (FTS) was appointed by Bouygues Travaux Publics (BTP) as the
Environmental Team (ET) under the Contract no. HY/2018/08 to execute the
environmental monitoring and audit (EM&A) programme under the issued EP (EP
No.: EP-457/2013/D) and in accordance with the EM&A Manual.
1.1.5 This is the 59th Monthly
EM&A Report prepared by FTS for the Contract No. HY/2018/08 Central Kowloon
Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19 September
2019. This report summarized the monitoring results and audits findings of the
EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in
accordance with the EM&A Manual during the reporting period from 01/07/2024
to 31/07/2024.
1.2.1 The Project Organization
structure is shown in Appendix B. The key personnel contact names
and numbers are summarized in Table 1.1.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint
Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited
(ERM) |
Independent Environmental
Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics
(BTP) |
Environmental Manager |
Mr. Simon Wong |
9281 4346 |
Fugro Technical Services
Limited |
ET Leader |
Mr. Calvin Leung |
3565 4441 |
1.3 Construction Programme and Activities
1.3.1 The construction phase of
this Contract under the EP commenced in October 2019. The site layout plan of

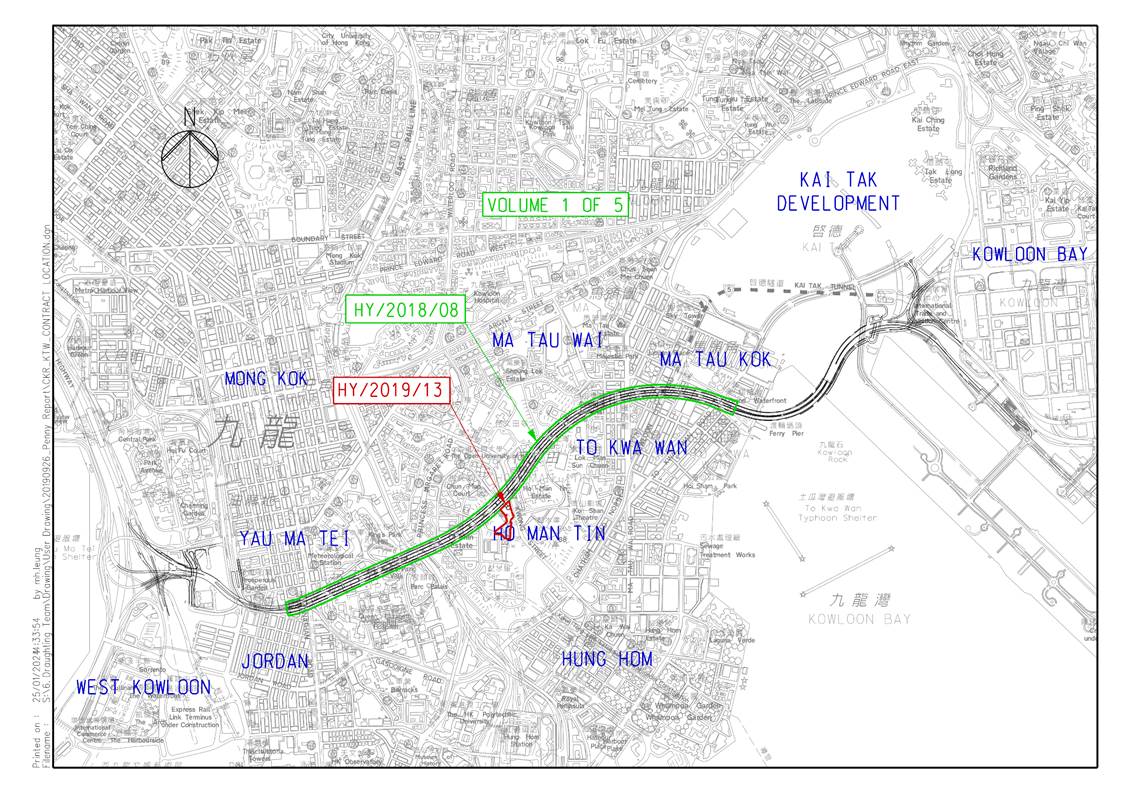

the Contract is shown in Figure 1.
1.3.2 The construction programme of
this Contract is shown in Appendix A.
1.4 Works undertaken during the month
1.4.1 The main construction works
carried out in the reporting period were as follow:
· Invert, lining and OHVD construction.
Yau Ma Tei
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Demolish of noise enclosure.
Ma Tau Kok
· Plant and material lifting;
· Invert, lining and OHVD construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Backfilling of C&C area.
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Backfilling and road reinstatement.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man
Tin site surface was substantially completed. The site had been handed over to
Contract No. HY/2019/13 on 30 December 2023.
1.5 Status of Environmental Licences, Notification and
Permits
1.5.1 A summary of the relevant
permits, licenses and/or notifications on environmental protection for this
Contract is presented in Table 1.2.
Table 1.2 Environmental
Licenses, Notification and Permits Summary
Reference No |
Valid From |
Valid Till |
|
Form NB |
448930, 448970, 448971 |
Mid-Sep 2019 |
NA |
Billing Account for Disposal of C&D waste |
Account no. 7034790 |
06 Aug 2019 |
NA |
Chemical Waste Producer Registration (Ho Man Tin Construction site) |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Chemical Waste Producer Registration (Yau Ma Tei Construction site) |
5213-225-B2557-05 |
19 Apr 2021 |
NA |
Chemical Waste Producer Registration (Ma Tau Kok Construction site) |
5213-247-B2557-06 |
19
Apr 2021 |
NA |
Construction Noise Permit |
|||
Construction
Noise Permit (Ho Man Tin Construction site) |
GW-RE0286-24 |
14
Mar 2024 |
13
Sep 2024 |
Construction
Noise Permit (Yau Ma Tei Construction site) |
GW-RE0602-24 |
17
May 2024 |
16
Nov 2024 |
Construction
Noise Permit (Yau Ma Tei Construction site) |
GW-RE0363-24 |
23
Mar 2024 |
22
Sep 2024 |
Construction Noise Permit (Ma Tau Kok
Construction site) |
GW-RE0581-24 |
9
May 2024 |
08
Nov 2024 |
Construction Noise Permit (Ma Tau Kok
Construction site) |
GW-RE0171-24 |
18
Feb 2024 |
17
Aug 2024 |
Construction Noise Permit (Kai Tak Barging Point) |
GW-RE0457-24 |
17
Apr 2024 |
11 Oct 2024 |
Water Discharge License |
|||
Water Discharge License |
WT00034873-2019 (Ho Man Tin Construction
site) |
22 Nov 2019 |
30 Nov 2024 |
WT00035436-2019 (Portion
18) |
02 Apr 2020 |
30 Apr 2025 |
|
WT00037723-2021 (Yau Ma Tei Construction
site) |
07 Apr 2021 |
30 Apr 2026 |
|
WT00037883-2021 (Ma Tau Kok Construction
site) |
30 Apr 2021 |
30 Apr 2026 |
|
WT00042304-2022 (Sheung Lok Street) |
13 Oct 2022 |
31 Oct 2027 |
|
WT10001427-20233 (Ma Hang Chung Road) |
4 Dec 2023 |
31 Dec 2028 |
2 ENVIRONMENTAL
MONITORING REQUIREMENTS
2.1 Construction Dust and Noise
Monitoring Locations
2.1.1 Three construction dust
monitoring locations and five construction noise monitoring locations pertinent
to the Project have been identified based on the approved EM&A Manual for
the Project. The locations of the construction dust and noise monitoring
stations are summarized in Table 2.1 as displayed in Figures
2.1 - 2.3.
Table 2.1 Construction
Dust and Noise Monitoring Locations
Dust Monitoring Station ID |
Noise Monitoring Station ID |
Monitoring Location |
M-A3 |
M-N3 |
SKH Tsoi Kung Po Secondary School |
/ |
E-N12a |
19 Hing Yan Street |
E-A14a |
E-N21a |
Block B of Merit Industrial Centre |
W-A6 |
/ |
Man Cheong building |
/ |
W-N18 |
Hydan Place |
/ |
W-N25A |
Prosperous Garden Block 1 |
Notes:
1. The dust and noise monitoring stations proposed in the EM&A Manual
for M-A6/ M-N6 (i.e. Ko Fai House, Kwun Fai Court) was not available for
impact dust and noise monitoring, therefore impact monitoring was conducted at
M-A3/ M-N3 as an alternative which was agreed by the ER, IEC and EPD;
2. The noise monitoring station proposed in the EM&A Manual for E-N12
(i.e. Grand Waterfront Tower 3) was not available for impact dust and
noise monitoring, therefore impact monitoring was conducted at E-N12a as an
alternative which was agreed by the ER, IEC and EPD;
3. The dust and noise monitoring stations proposed in the EM&A Manual
for E-A14 (i.e. Wyler Gardens) and E-N21 (i.e Hang Chien Court Block J)
was not available for impact dust and noise monitoring, therefore impact
monitoring was conducted at E-A14a/ E-N21a as an alternative which was agreed
by the ER, IEC and EPD;
4. The dust monitoring stations proposed in the EM&A Manual for W-A5
(i.e. The Coronation) was not available for impact dust monitoring,
therefore impact monitoring was conducted at W-A6 as an alternative which was
agreed by the ER, IEC and EPD.
2.1.2 The last impact monitoring
conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023.
Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental
Team of Contract HY/2019/13 since January 2024 (Figure 2.1).
2.1.3 The construction dust and
noise monitoring locations at M-A3 and M-N3 are covered by Contract No.
HY/2019/13 Central Kowloon Route – Buildings, Electrical and Mechanical Works.
The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A
Report prepared by Contract No. HY/2019/13.
2.1.4 The construction dust and
noise monitoring locations at E-A14a, E-N12a and E-N21a are now covered by
Contract No. HY/2014/07 Central Kowloon Route – Kai Tak West. The
monitoring results at E-A14a, E-N12a and E-N21a in the reporting month are
presented in the monthly EM&A Report prepared by Contract No. HY/2014/07.
2.1.5 The construction dust and
noise monitoring locations at W-A6, W-N18 and W-N25A are now covered by
Contract No. HY/2014/08 Central Kowloon Route –Yau Ma Tei East. The monitoring
results at W-A6, W-N18 and W-N25A in the reporting month are presented in the
monthly EM&A Report prepared by Contract No. HY/2014/08.
2.2 Construction Dust Monitoring
Monitoring Requirement
2.2.1 In accordance with the
approved EM&A Manual, 1-hour and 24-hour Total Suspended Particulates (TSP)
levels should be measured at the designated air quality monitoring stations to
indicate the impacts of construction dust on air quality. Regular Impact
24-hour TSP monitoring should be carried out for at least once every 6 days,
and 1-hour TSP monitoring should be done at least 3 times every 6 days when the
highest dust impact occurs.
Monitoring Equipment
2.2.2 24-hour TSP air quality
monitoring was performed using High Volume Sampler (HVS) deployed at the
designated monitoring station. The HVS shall meet all the requirements of the
EM&A Manual.
2.2.3 A portable direct reading
dust meter was used to carry out the 1-hour TSP monitoring.
2.3 Construction Noise Monitoring
Monitoring Requirement
2.3.1 In accordance with the
EM&A Manual, impact noise monitoring should be conducted at the designated
noise monitoring stations for at least once a week during the construction
phase of the Project. The parameters, frequency and duration of impact noise monitoring
is summarized in Table 2.2.
Table 2.2 Construction
Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted equivalent continuous sound pressure level (Leq). L10 and L90 were also recorded |
30 minutes |
At least once per week |
Monitoring Equipment
2.3.2 Noise monitoring was
performed using sound level meter at the designated monitoring station. The
sound level meters deployed comply with the International Electrotechnical
Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1) specifications.
Acoustic calibrator was deployed to check the sound level meters at a known
sound pressure level.
2.4.1 As per the EM&A Manual,
the landscape and visual mitigation measures shall be implemented and site
inspections should be undertaken once every two weeks during the construction
period. A summary of the implementation status is presented in Section
4.
3 ENVIRONMENTAL
MONITORING RESULTS
3.1 Construction Dust Monitoring
3.1.1 The last impact monitoring
conducted by ET of Contract HY/2018/08 was on 27 December 2023. Impact
monitoring at M-A3 was subsequently conducted by Environmental Team of Contract
HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented
in the monthly EM&A Report prepared by Contract No. HY/2019/13.
3.1.2 No Action and Limit Level
exceedance was recorded for construction dust monitoring in the reporting
month.
3.2 Construction Noise Monitoring
3.2.1 The last impact monitoring
conducted by ET of Contract HY/2018/08 was on 27 December 2023. Impact
monitoring at M-N3 was subsequently conducted by Environmental Team of Contract
HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented
in the monthly EM&A Report prepared by Contract No. HY/2019/13.
3.2.2 No Action and Limit Level
exceedance was recorded for construction noise monitoring in the reporting
month.
3.3.1 Auditing of waste management
practices during regular site inspections confirmed that the waste generated
during construction were properly, stored, handled and disposed of in general. The Contractor was responsible for the implementation of any mitigation
measures to reduce waste or redress issues arising from the waste materials.
3.3.2 The implemented environmental
mitigation measures for the waste management in the reporting period are
summarized in Appendix D. The summary of observations and
recommendations made for waste management during the site inspections are
presented in Table 4.1.
3.3.3 Monthly summary of waste flow
table is detailed in Appendix F.
3.4.1 Bi-weekly inspections of the
implementation of landscape and visual mitigation measures were conducted on 2,
16 and 30 July 2024. The implementation the landscape and visual mitigation
measures in the reporting period are summarized in Appendix D. The
summary of observations and recommendations made for landscape and visual
mitigation measures during the site inspections are presented in Table
4.1.
3.4.2 The Event and Action Plan for
landscape and visual during construction phase is given in Appendix C.
4 ENVIRONMENTAL
SITE INSPECTION AND AUDIT
4.1.1 Site inspections were carried
out on a weekly basis to monitor the implementation of proper environmental
pollution control and mitigation measures for the Project. A summary of the
mitigation measures implementation status is provided in Appendix D.
4.1.2 In the reporting month, five
site inspections were carried out on 2, 9, 15 (with IEC), 23, and 30 July 2024.
Details of observations recorded during the site inspections are presented
in Table 4.1.
Table 4.1 Observations
and Recommendation of Site Inspection in the Reporting Period
Environmental Aspect |
Date |
Observations, Reminders, and Recommendations |
Follow-up Actions |
Air Quality |
Nil |
Nil |
Nil |
Nil |
Nil |
Nil |
|
Noise |
Nil |
Nil |
Nil |
Water
Quality |
Nil |
Nil |
Nil |
Waste
Management |
Nil |
Nil |
Nil |
Landscape and Visual |
Nil |
Nil |
Nil |
Permit/ Licenses |
Nil |
Nil |
Nil |
5 ENVIRONMENTAL
COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling,
Prosecution and Public Engagement
5.1.1 No complaints were received
in the reporting month.
5.1.2 The complaint cases in July
2024 are summarized in Table 5.1.
Table 5.1 Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
Nil |
5.1.3 Cumulative complaint log, summaries of complaints, notification of
summons and successful prosecutions are presented in Appendix E.
5.1.4 No public engagement
activities were conducted in the reporting period.
5.2 Summary of Environmental
Non-Compliance
5.2.1 No environmental
non-compliance was recorded in the reporting period.
5.3 Summary of Monitoring
Exceedance
5.3.1 The last impact monitoring
conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023.
Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental
Team of Contract HY/2019/13 since January 2024. The
monitoring results at M-A3 and M-N3 are presented in the monthly EM&A
Report prepared by Contract No. HY/2019/13.
5.3.2 No Action and Limit Level
exceedance was recorded for construction dust monitoring in the reporting
month.
5.3.3 No Action and Limit Level
exceedance was recorded for construction noise monitoring in the reporting
month.
6 IMPLEMENTATION
STATUS OF ENVIRONMENTAL MITIGATION MEASURE
6.1.1 The Contractor had
implemented environmental mitigation measures and requirements as stated in the
EIA Report, the EP and EM&A Manual. The implementation status of the
environmental mitigation measures during the reporting period is summarized in Appendix

D. Status of required submissions under the EP during the reporting period
is summarised in Table 6.1.
Table 6.1 Status
of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (June 2024) |
10 July 2024 |
7.1.1 The main works will be
anticipated in the next reporting period are as follow:
Yau Ma Tei
· Plant and material lifting;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Demolish of noise enclosure & Gantry Crane.
Ma Tau Kok
· Plant and material lifting;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Cut and cover construction;
· Backfilling of C&C area;
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Backfilling and road reinstatement.
Ma Hang Chung Road
· Backfilling and road reinstatement.
7.1.2 The recommended mitigation
measures corresponding to the main works in the next reporting period are
listed as follows:
· Good relationship shall be maintained with the nearby sensitive
receivers/ stakeholders which may be affected by the construction works such as
providing better/ more detail information of the work nature and inform in
advance of the works to the nearby residents;
· All construction plants / machineries should be checked / serviced on a
regular basis during the courses of construction to minimize the emission of
noise generation and eliminate dark smoke emission;
· All C&D materials generated should be transported and stored at
temporary storage area. Suitable materials should be sorted for reuse on-site;
· Every vehicle shall be cleaned thorough at the designated wheel washing
area onsite;
· Wastewater generated from drilling shall be properly collected for reuse
or treated by wastewater treatment facilities before discharge;
· Provision of drip trays for equipment likely cause spillage of chemical /
fuel, and provide routine maintenance;
· Erecting temporary noise barrier for noisy Powered Mechanical Equipment
(PME) and deployment of Quality Powered Mechanical Equipment (QPME) as many as
practicable;
· Conditions in the Environmental Permit and License should be followed;
· All recommended mitigation measures specified in the approved EIA Report
and EM&A Manual shall be implemented.
· All vehicles should be cleaned before leaving the construction site to
ensure no muddy deposited by them on roads.
8 CONCLUSION
AND RECOMMENDATIONS
8.1.1 The 59th Monthly

EM&A Report for the Contract No. HY/2018/08 Central Kowloon Route – Central
Tunnel summarized the monitoring results and audits findings of the EM&A
programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with
the EM&A Manual during the reporting period from 01/07/2024 to 31/07/2024.
8.1.2 No construction noise
monitoring was conducted in the reporting month as the site had been handed
over to Contract No. HY/2019/13 on 30 December 2023. Impact monitoring at M-A3/
M-N3 has been conducted by Environmental Team (HY/2019/13) since January 2024.
8.1.3 No Action and Limit Level
exceedance was recorded for construction noise monitoring in the reporting
month. No Action and Limit Level exceedance was recorded for construction dust
monitoring in the reporting month.
8.1.4 Weekly environmental site
inspections were conducted during the reporting period. In general, the
Contractor had implemented environmental mitigation measures and requirements
as stated in the EIA Report, the EP and EM&A Manual.
8.1.5 No complaints were received
in the reporting month.
8.1.6 No environmental related
prosecutions or notification of summons were received in the reporting period.
8.1.7 No environmental
non-compliance was recorded in the reporting period.
8.1.8 According to the
environmental site inspections performed in the reporting month, the following
recommendations were provided:
Air Quality Impact
· No specific observation was identified in the reporting month.
Construction Noise Impact
· No specific observation was identified in the reporting month.
Water Quality Impact
· No specific observation was identified in the reporting month.
Waste Management
· No specific observation was identified in the reporting month.
Landscape and Visual Impact
· No specific observation was identified in the reporting month.
Permit/ Licenses
· No specific observation was identified in the reporting month.
